Los Árboles Adds New Pillars to Its Load-Bearing Structure

Construction Progress

With new foundation pile caps, beams and concrete columns already in place, Park Lofts Los Árboles’ load-bearing structure keeps taking shape as soil improvement and septic chamber work move forward.

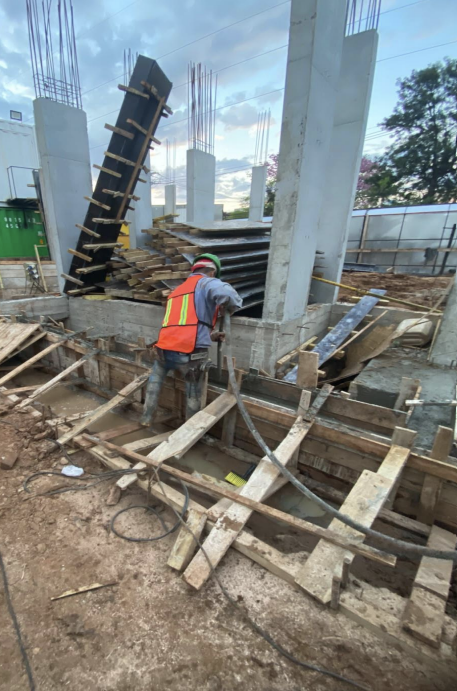

Concrete pouring of foundation pile caps and reinforced concrete columns at Park Lofts Los Arboles
Concrete pouring of foundation pile caps and reinforced concrete columns on site at Los Árboles.

The team continued with the rebar assembly, formwork and concrete pouring of new foundation pile caps, foundation beams and reinforced concrete columns. In parallel, soil backfilling and compaction moved forward, along with chemical stabilization and ground improvement measures.

Work also included shoring up a section of the adjoining wall, plastering those walls, and additional excavation to bring the septic chamber to its planned elevation.

Pouring underwayNew foundation pile caps, beams and reinforced concrete columns
UnderwayChemical stabilization and soil improvement
Septic chamberAdditional excavation to the planned elevation
Next milestoneLoad-bearing structure rising

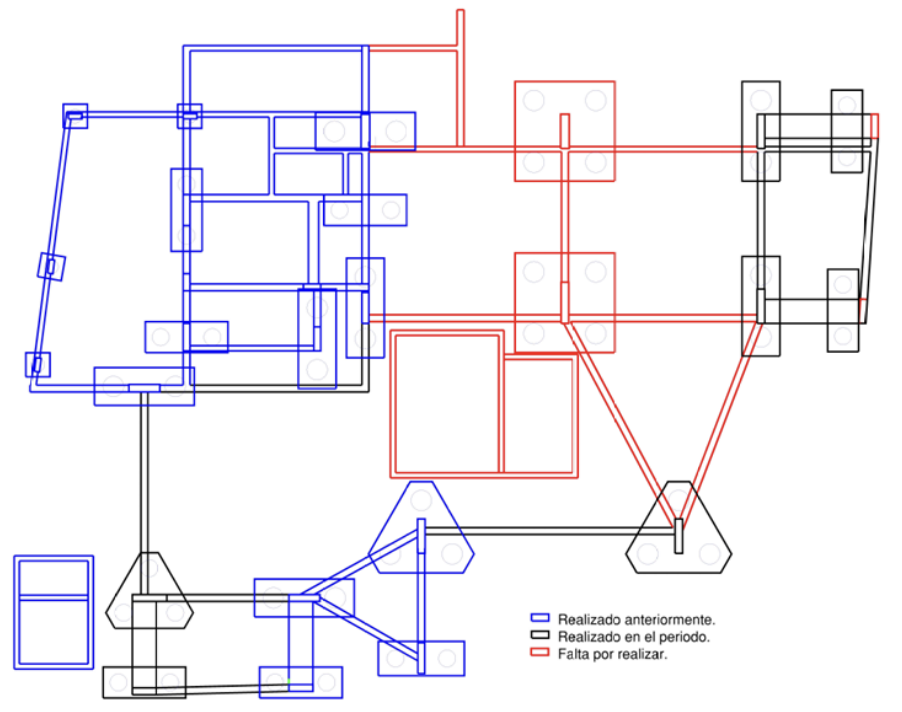

Updated foundation progress plan for Park Lofts Los Arboles
Updated foundation plan: in blue, work completed before the period; in black, work completed during the current period; in red, work planned for the next stage.

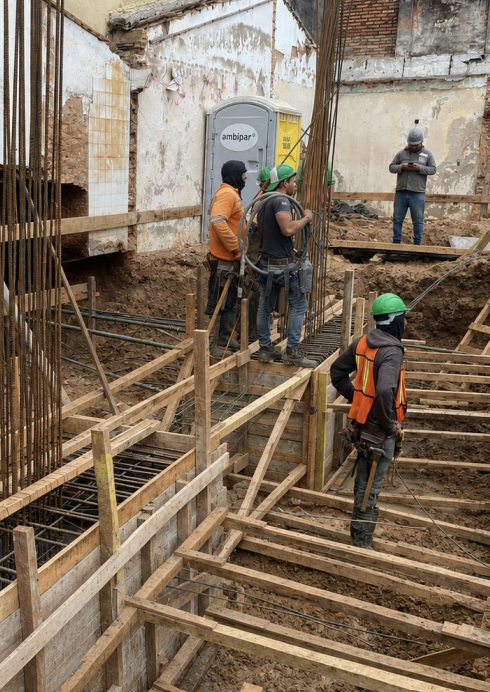

Rebar assembly and shoring work on adjoining walls at Park Lofts Los Arboles
Rebar assembly and shoring work on the adjoining walls.

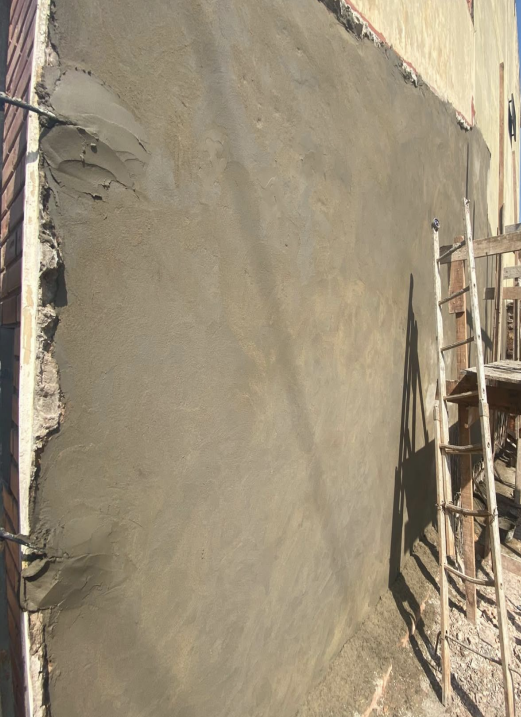

Plastering of adjoining wall at Park Lofts Los Arboles
Plastering of the adjoining walls.

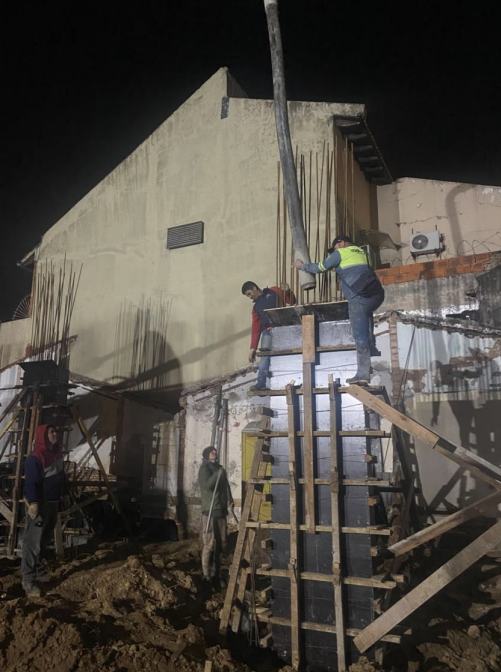

Night-time concrete pour of structural elements at Park Lofts Los Arboles
Night-time concrete pour of one of the foundation pile caps.

With each foundation section completed, the building’s load-bearing structure keeps taking shape and lays the groundwork for the next construction phases. The project keeps moving forward steadily: even with rainy days during the period, work on the foundations, the reinforced concrete columns and the other preparatory elements was able to continue as planned.

Over the coming weeks, work is expected to continue on the assembly, formwork and pouring of the remaining pile caps, beams and columns, along with continued backfilling, compaction and soil improvement, additional work on the septic chamber, continued work on the adjoining walls, and preparation for the next stages of the building’s load-bearing structure.
